Creek Bank Stabilization: A Landholder’s Action Guide

Hands planting willow stakes on creek bank with rock toe

Most persistent creek bank erosion is best fixed by stabilizing the bank toe with rock or engineered woody material, then establishing riparian vegetation above it. Skip the toe work and even a beautifully planted slope will slump within a season or two, because scour keeps undercutting the roots.

Do this first:

  • Fence livestock at a recommended distance back from the bank, typically at least 10 metres, with greater distances advised for larger streams or erosion-prone areas.
  • Photograph and mark the eroding toe now, so you can measure change over the next few months.
  • If the bank is failing fast, lay temporary coir logs or sandbags at the toe while you plan permanent works.

If you see undermined structures, active slumping, or exposed utility lines, stop and call a contractor immediately, and confirm what approvals your council or state agency requires before touching the channel. Government guidance from NSW’s riverbank erosion program and hands-on rock work from crews like Rokworx both point the same direction: fix the toe, then plant.

Key Takeaways

Durable creek bank stabilization pairs structural toe protection below the waterline with native revegetation above it, because bioengineering alone rarely survives contact with moving water at the base.

Point Details
Fix the toe first Rock or engineered woody structures at the base stop the scour that causes slope failure.
Diagnose upstream causes Check for blockages, land use change, or neighboring works before repairing your own bank.
Match method to urgency Use coir logs or sandbags only as a bridge while you plan permanent rock or bioengineering works.
Check permits before starting Confirm with your local agency, since in-stream and vegetation-clearing work often needs approval.
Inspect through establishment Check seasonally for two to three years and after every major flood event.
Call Rokworx for structural work Rokworx supplies graded rock and handles excavation and rock wall construction for toe protection projects.

Table of Contents

What Causes Creek Bank Erosion and How Do You Diagnose It?

Streambank failure almost always traces back to one of four drivers: increased flow velocity from upstream development, a shift in channel alignment, scour undercutting the toe, or loss of vegetation that once held the soil together. Layered soils make it worse. A sandy layer under a clay cap erodes unevenly, creating an overhang that eventually collapses under its own weight.

Before you touch a shovel, build a diagnostic picture:

  1. Measure bank height and slope angle at the worst point.
  2. Check how much of the toe sits exposed below the waterline.
  3. Look upstream for culverts, fallen trees, or fencing that might be redirecting flow.
  4. Note vegetation cover on both banks, not just yours.
  5. Photograph the site from the same spots every few months.

Erosion is often a symptom, not the disease. If a neighbor upstream cleared vegetation or straightened a bend, your bank absorbs the consequences. NSW government guidance stresses that repairing one property’s bank without addressing upstream causes often just relocates the problem downstream. Talk to neighbors before committing to expensive works.

Should You Use Quick Fixes or Long-Term Solutions?

That depends on how much time you have before the next rain event. Emergency measures buy you weeks, not years:

  • Sandbags at the toe slow scour but degrade within months and need constant replacement.
  • Temporary coir logs hold soil while plants establish, but they biodegrade in roughly 4 to 6 years even in ideal conditions.
  • Silt fencing catches sediment but does nothing for the underlying hydraulic problem.

Long-term stability comes from combining a rock or engineered toe with revegetation above it. This is the approach Penn State Extension recommends because bioengineering alone rarely survives contact with fast-moving water at the waterline. Use temporary fixes only while you plan or wait for permits. If you’re facing a wet winter and a crumbling bank, spend the money on permanent works now. Repeated emergency patches cost more over five years than one properly built toe.

How Do Bioengineering Methods Stabilize a Bank?

Living structures work well on the upper and mid bank, where erosive force is lower and roots can actually take hold. The main techniques:

  1. Live staking — driving dormant cuttings of willow, dogwood, or other rooting species directly into the soil, where they sprout and knit the bank together.
  2. Live fascines — bundles of live branches laid in shallow trenches along the contour, which sprout and slow surface flow.
  3. Brush mattressing — a woven layer of branches pinned against the slope, often combined with live stakes driven through it.
  4. Joint planting — tucking rooted plants or cuttings into the gaps of an existing rock structure.
  5. Vegetated geogrids — soil wrapped in fabric layers with plants rooted between them, building the bank up in lifts.
  6. Coir logs — cylindrical fiber rolls staked along the low bank to trap sediment while plants establish behind them.

Choose local native riparian species. They’re adapted to your soil, flood timing, and local pest pressure, and they establish faster than nursery imports chosen for looks. Plant in the dormant season where possible, and water new plantings through their first dry spell.

Pro Tip: If you’re staking a temporary geotextile, choose coir over jute for anything you expect to outlast one growing season. Coir typically holds together for 4 to 6 years versus jute’s 1 to 3, which matters if your plants are slow to establish.

None of this works below the waterline on its own. Roots need oxygen and stable ground to grow into, and a bank that’s still being scoured at the base will fail regardless of how well the top is planted. That’s why every serious bioengineering plan pairs with structural toe protection.

What Structural Methods Protect the Bank Toe?

Toe failure is the most common reason stabilized banks collapse. Scour eats away the base, the bank above loses support, and the whole slope slumps, taking your careful planting with it. Structural methods exist to stop exactly that.

  • Rock riprap and buried rock toes are the standard fix. Rock is sized to resist the stream’s design flow, laid over filter fabric or geotextile to stop fine soil from washing out from underneath, and extended up to at least the design flood level.
  • Buried toe trenches filled with graded rock and wrapped in geogrid create a stable footing that vegetated layers can be built on top of, a construction pattern detailed in field manuals like the Harris County Streambank Stabilization Handbook.
  • Timber fillets and engineered woody debris slow flow and trap sediment while adding fish and invertebrate habitat, a method regional agencies are increasingly recognizing as part of formal stabilization design.
  • Retaining walls or gabions become necessary when space is tight, the bank is steep, or you’re protecting a structure like a driveway or shed. If your toe is already undermined or the channel has incised more than a foot or two, get an engineered design rather than guessing at rock sizing yourself.

Rokworx builds rock walls and installs buried rock toe protection using locally sourced rock sized to the site, which is the detail most DIY riprap jobs get wrong.

How Do You Choose the Right Stabilization Method?

Walk the site with a checklist before deciding on anything. You need six data points: bank slope angle, soil type and layering, how much toe sits exposed below waterline, what’s driving the flow (culvert, bend, upstream clearing), machinery access, and what assets sit at risk if the bank fails further.

  1. Measure slope and soil layering first. Steep, layered, sandy-under-clay banks need structural toe work almost every time.
  2. Ask any contractor quoting the job for an expected design life, not just a price.
  3. Confirm the toe detail specifically. This is where budget corners get cut and where failures start.
  4. Ask what permits the work requires and who’s responsible for lodging them.
  5. Ask what happens if erosion recurs. A reputable operator has a maintenance or warranty answer, not a shrug.

Watch for red flags that mean you need an engineer, not a weekend project: an undermined toe you can see daylight under, a channel that has cut down more than 30 to 50 centimeters below its old bed, or erosion wrapping around the end of an existing structure. Practitioners treat toe stability as the priority precisely because a well-planted slope with a scoured base is a slow-motion failure, not a fix.

Do You Need a Permit for Creek Bank Work?

Rules vary by state and by what you’re actually doing, so check before you start.

  • In-stream works, removing woody debris, or excavating within the channel often require approval, even on private land.
  • Clearing riparian vegetation can trigger environmental or cultural heritage checks, especially near mapped waterways.
  • Many straightforward bank repairs are exempt from licensing, but confirm with your local agency before assuming yours qualifies.
  • On site, treat flowing water and wet banks as a fall and entrapment hazard, and keep machinery well clear of undercut edges that can collapse under load.

How Often Should You Inspect and Maintain a Stabilized Bank?

Check the site after every major flood, and at least seasonally for the first two to three years while plantings establish. That establishment window is when active management matters most: weekly checks during heavy rain periods catch problems before they become expensive.

  1. Look for rock that’s shifted or rolled away from the toe line.
  2. Check for erosion forming beneath or behind new plantings.
  3. Clear trapped debris that could lever out stakes, logs, or rock.
  4. Reseed or replant any bare patches, and keep weeds down while roots establish.

What Does a Real Bank Stabilization Project Look Like?

Rokworx handles the full range, from rock supply and rock wall construction to the earthmoving and excavation that toe protection actually requires.

  • A typical small job runs: site visit and assessment, scope and quote, then install, often inside a week for straightforward toe work.
  • Common jobs include driveway washout repair after a storm event and rock toe installation on eroding backyard creek banks.
  • Melbourne landholders use Rokworx for both the supply of graded rock and the machinery to place it correctly against a live bank.

What Does Creek Bank Stabilization Cost?

Costs scale with bank length, toe exposure, and whether you’re using rock, timber, or bioengineering alone. Temporary measures are the cheapest entry point. Coir logs and stakes cost relatively little in materials, but labor for correct installation and the recurring cost of replacement every few years adds up if the underlying cause isn’t fixed.

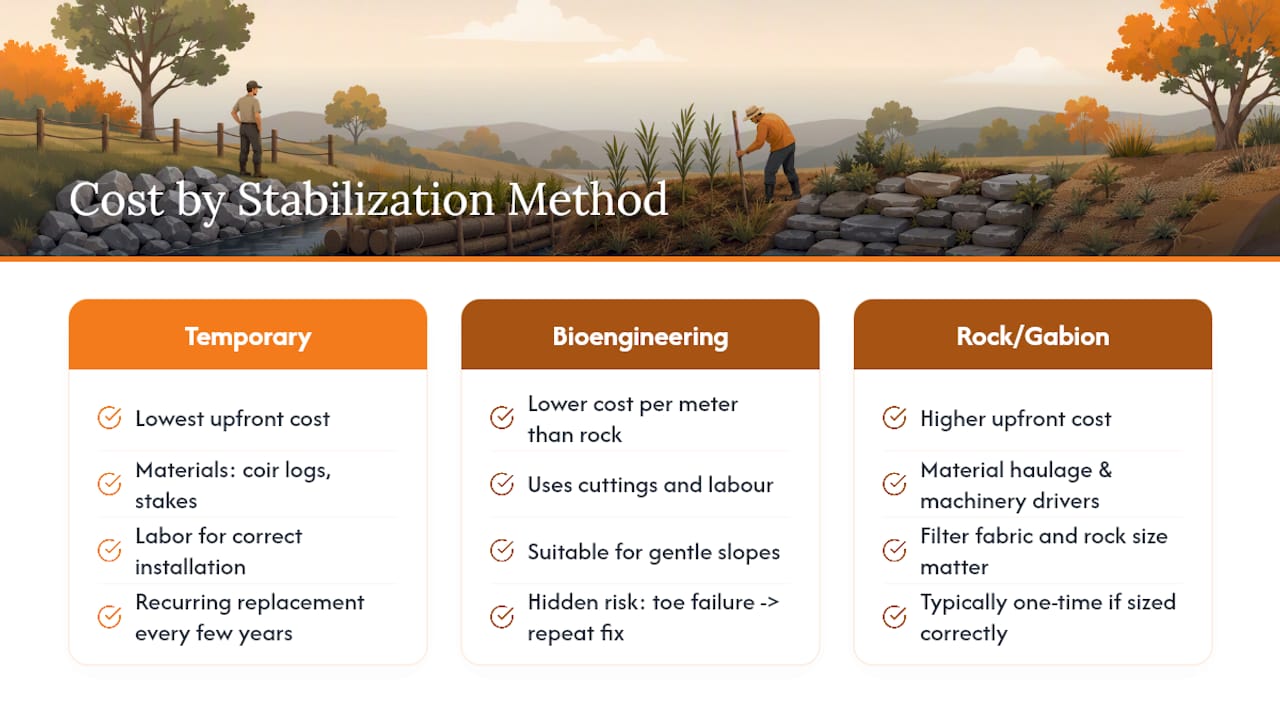

Cost comparison of creek bank stabilization methods

Bioengineering-only projects (live staking, fascines, brush mattressing) tend to cost less per meter than rock work because they use cuttings and labor rather than trucked-in material. They’re a reasonable choice for gently sloping banks with minimal toe exposure. But they carry hidden cost risk: if the toe fails after two seasons because it wasn’t protected, you’re paying for the fix twice.

Rock toe protection carries higher upfront cost because of material haulage, machinery time, and filter fabric, but it’s typically a one-time spend if sized correctly for your stream’s flow. Retaining walls and engineered gabion structures sit at the top of the cost range and are usually reserved for sites protecting a structure, driveway, or significant asset.

Budget for three cost centers separately: site assessment and any required engineering advice, materials (rock, geotextile, plants, stakes), and installation labor or machinery hire. Get quotes that separate these line items, because a low headline price sometimes means the toe detail has been skipped to hit a number. Ask specifically what rock size and depth is included, and whether filter fabric is part of the quote or an add-on. A site visit from Rokworx will typically break the job down this way before you commit to a scope.

When Should You Schedule Stabilization Work?

Timing affects both cost and success rate. Dormant season, typically late autumn through winter in temperate zones, is the best window for live staking and planting, because cuttings root before the growing season demands water they can’t yet draw. Structural rock work has more flexibility but is easier and safer to schedule during lower flow periods, when the channel bed is exposed and machinery access is drier.

A sensible sequence looks like this: assess and diagnose first, ideally after walking the site in both wet and dry conditions to understand how flow actually behaves. Lodge any required permits next. Approval timelines vary by jurisdiction, so build in weeks, not days, especially for in-stream work. Install toe protection before or alongside planting, never after. Planting into an unstable toe wastes the plants.

Sequence the physical work toe-up: rock or woody toe structure first, geotextile and fill next, then vegetation on top. Reversing that order is one of the most common DIY mistakes, since planting first means machinery for toe work later tramples the new growth.

Plan for a follow-up visit within the first three to six months to check establishment, then shift to the seasonal inspection routine covered earlier. If your project spans a full growing season, expect a second short planting phase to fill gaps where the first round didn’t take, which is normal and not a sign of failure.

What Equipment and Materials Do You Need?

Sourcing the right materials before you start prevents the mid-project scramble that blows budgets and timelines.

For structural toe work: graded rock sized to your stream’s flow rating, filter fabric or geotextile, and access for an excavator or similar machine capable of placing rock accurately against a live bank. Rokworx supplies rock and handles the excavation side of this together, which avoids the common problem of ordering rock that doesn’t match what your access allows you to place.

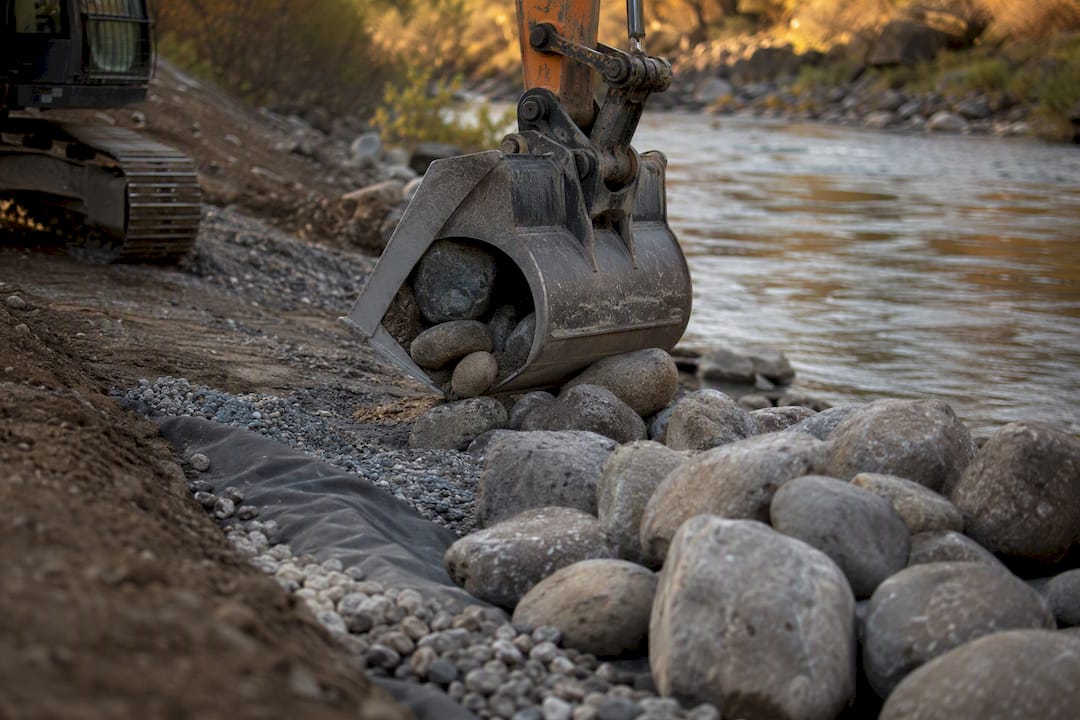

Excavator placing rock for creek bank stabilization

For bioengineering: dormant cuttings of local native riparian species (willow, dogwood, and similar rooting stock are common choices), coir logs or jute matting depending on how long you need the material to hold, wooden stakes for anchoring, and basic hand tools for planting.

For woody structures: sourced logs or engineered woody debris, cabling or anchoring hardware if the design calls for it, and machinery to position larger pieces.

Don’t forget the unglamorous items that projects often skip: erosion control matting for bare soil between plantings, mulch to retain moisture around new stock, and simple survey stakes or flagging tape to mark your monitoring points for the seasonal checks described earlier. A basic materials checklist before ordering saves a second delivery fee and a second wasted site visit.

What Environmental Impacts Should You Watch For?

Bank work done poorly can cause more damage than the erosion it’s meant to fix. Machinery compacting riparian soil, sediment runoff into the waterway during construction, and disturbance to fish habitat during in-stream work are the three most common issues.

Mitigate sediment runoff by working during lower flow periods and using silt fencing or sediment curtains downstream of active work. Limit machinery tracks to a single access route rather than driving across the whole site, which reduces soil compaction that can itself worsen future erosion. Time any in-stream disturbance to avoid fish spawning windows relevant to your region, and check with your local agency about protected species before removing woody debris, since submerged logs and snags often provide habitat even when they look like clutter.

Silt fencing controlling sediment runoff near creek

Native revegetation isn’t just cosmetic. It restores shade that keeps water temperature down for aquatic life and rebuilds the root structure that prevents the next erosion cycle. Choosing structural methods that also support habitat, like timber fillets and engineered woody debris, gets you stabilization and ecological benefit from the same spend rather than treating them as competing priorities.

When Should You DIY and When Should You Call In a Contractor?

Small jobs, like fencing off livestock or planting native stakes along a gently sloping bank, are well within reach for a capable landholder. Once you’re placing rock below the waterline, operating machinery near an undercut bank, or facing an already-slumping toe, bring in a professional. Approvals, correct rock sizing, and the cost of a repeat failure make DIY the expensive option past that point.

— MYBMC

Get a Site Visit and Quote From Rokworx

Rokworx is the practical alternative to piecing together a stabilization job yourself from rented equipment and mismatched rock. If you’ve read through the toe protection and rock sizing sections above and realized your bank needs structural work, that’s exactly where a dedicated rock and earthmoving crew earns its keep over a DIY attempt.

Rokworx

Rokworx handles the parts landholders find hardest to source correctly: graded rock supply matched to your stream’s flow, rock wall construction built to hold against real hydraulic pressure, and the excavation needed to place a toe properly rather than guessing at it from the bank edge. A typical engagement starts with a site visit, where slope, soil, and access get assessed on the ground, followed by a scoped quote and then installation. If your bank has an exposed or undermined toe, get a quote for the fix before the next rain event makes the job bigger.

Sources

For deeper technical detail, NSW’s riverbank erosion guidance and its companion waterways protection page cover diagnosis and approvals in depth. Penn State Extension breaks down bioengineering versus structural methods, and NSW Marine Estate’s project pages document real combined-method outcomes. Always confirm current approval requirements with your own local agency before starting work.

4 Comments

  • pkluky97

    3 September 2026 - 2:26 am

    I really appreciate how easy it is to navigate this site. Even for beginners it is very straightforward. Give pkluky97 a try!

  • plataforma345vip

    8 September 2026 - 12:28 pm

    Super easy to navigate and the bonuses are actually worth it. I am really enjoying my time on plataforma345vip

  • ph10jilicc

    9 September 2026 - 9:07 am

    I’ve been trying a few sites lately and this one is actually smooth. The payouts are fast and the interface is very user friendly. Definitely recommend ph10jilicc to anyone looking for a reliable spot.

  • ph91jili

    11 September 2026 - 3:31 am

    The payout process is surprisingly fast. Had a great run last night on ph91jili, highly recommend it to everyone!

Leave A Comment

x

Get A Quote

    When do you plan on starting this project?
