Locating Underground Services Before You Dig or Build

Vacuum excavation exposing underground pipe

Before you break ground for a retaining wall, a rock garden bed, or an earthmoving job, lodge a free enquiry with Before You Dig Australia (BYDA). Treat whatever plans come back as a starting point, not gospel. Then physically confirm every marked service by potholing, either hand digging or vacuum excavation, before any machine touches the ground. Locating underground services this way is not a suggestion buried in fine print. It is the sequence that keeps you off the news and out of a hospital bed.

A few things stay true no matter the size of your project:

  • BYDA responses are indicative plans, not surveyed locations.
  • Machinery has no business near a marked service until it has been visually exposed.
  • Your findings need to be documented and referenced in your Safe Work Method Statement (SWMS), following AS5488 quality levels.

Key Takeaways

Locating underground services safely requires a BYDA enquiry, physical verification through potholing, and documented compliance with AS5488 and WHS excavation codes before any machine starts digging.

Point Details
Lodge BYDA first Submit a free enquiry with exact site details before any planning begins.
Treat plans as indicative BYDA responses are typically Quality D records, not surveyed locations.
Verify by exposure Pothole by hand or vacuum excavation at every crossing before mechanical digging.
Document to AS5488 Record depth, alignment, and photos to reach Quality A for your SWMS.
Call specialists when needed Tight access, congested yards, or high-voltage proximity justify a certified locator or experienced excavation contractor.

Table of Contents

Getting Your Paperwork and Site Details Ready

A BYDA enquiry only works as well as the information you feed it. You need the exact dig site address, the boundaries of your work area, the type of work (excavation, trenching, rock wall footings), and your intended start date. Whoever lodges the enquiry, whether that is the homeowner, the landscaper, or a project manager, should be the same person who follows up with asset owners if a plan comes back unclear or incomplete.

Before you even submit the enquiry, walk the site and collect your own clues:

  1. Note the location of water meters, gas meters, and stormwater pits.
  2. Pull any building permits or previous landscaping plans that mention service lines.
  3. Ask the property owner about past renovations, irrigation installs, or additions, since most domestic lead-ins never appear on a utility map at all.
  4. Check for recent trenching scars, valve covers, or electrical pit lids in the work zone.

Pro Tip: Keep a single running file, digital or paper, of every BYDA response, every phone call to an asset owner, and every photo you take on site. That file becomes your SWMS backbone and saves you when a council inspector or an insurer asks how you knew where to dig.

Combining a BYDA enquiry with physical site clues and later, direct detection work is what the BYDA tri-fold brochure describes as a layered approach, and it is the only reliable way to catch private services that public plans miss entirely.

Which Locating Methods Actually Find Buried Pipes and Cables?

A BYDA plan tells you which asset owners have infrastructure near your site. It does not tell you exactly where that infrastructure sits, and it rarely tells you how deep it runs. Most residential plans come back at Quality D under the AS5488 classification system, meaning the data is drawn from records rather than field survey. That is a reasonable starting point. It is not a coordinate.

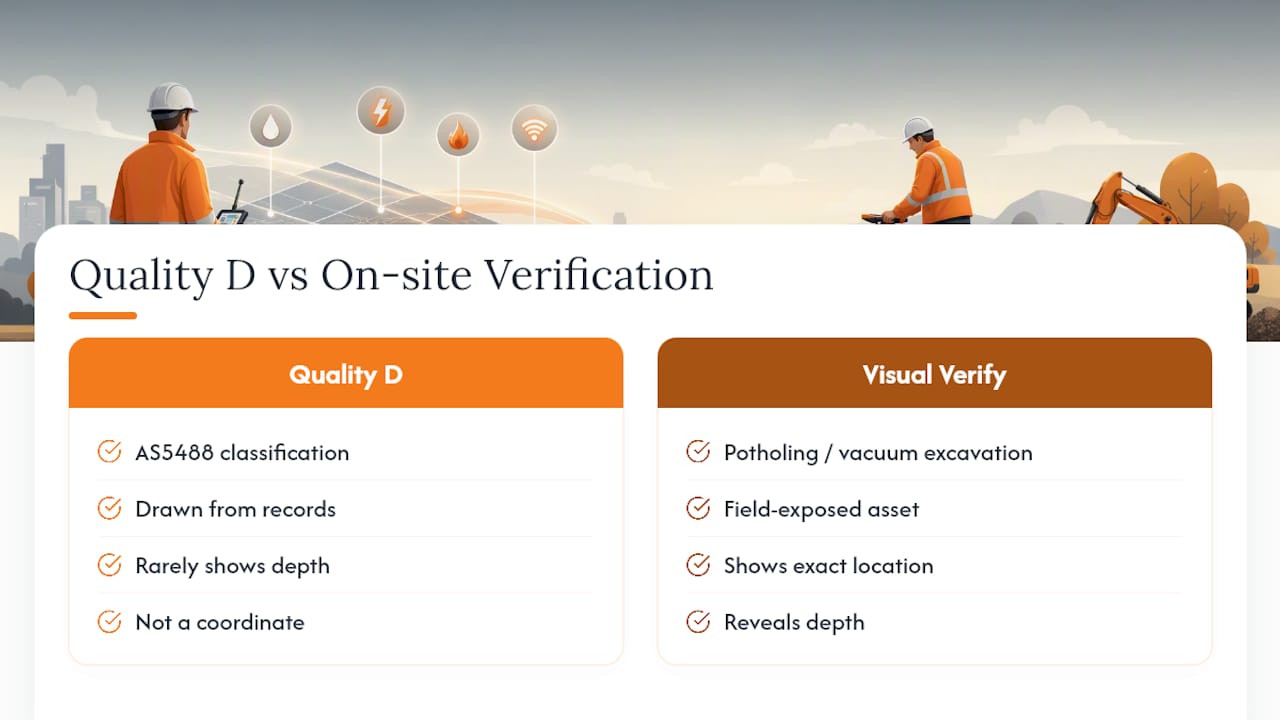

Diagram of AS5488 data quality classifications

Electronic locators pick up conductive services like metal water pipes, electrical conduit, and some telecommunications cable, but they struggle with plastic gas lines or poly irrigation pipe unless a tracer wire was laid alongside them. Ground-penetrating radar (GPR) can help in complex, congested private yards where multiple unmapped services might be present, though dense clay soils and shallow rock can distort the readings. Neither tool replaces your eyes.

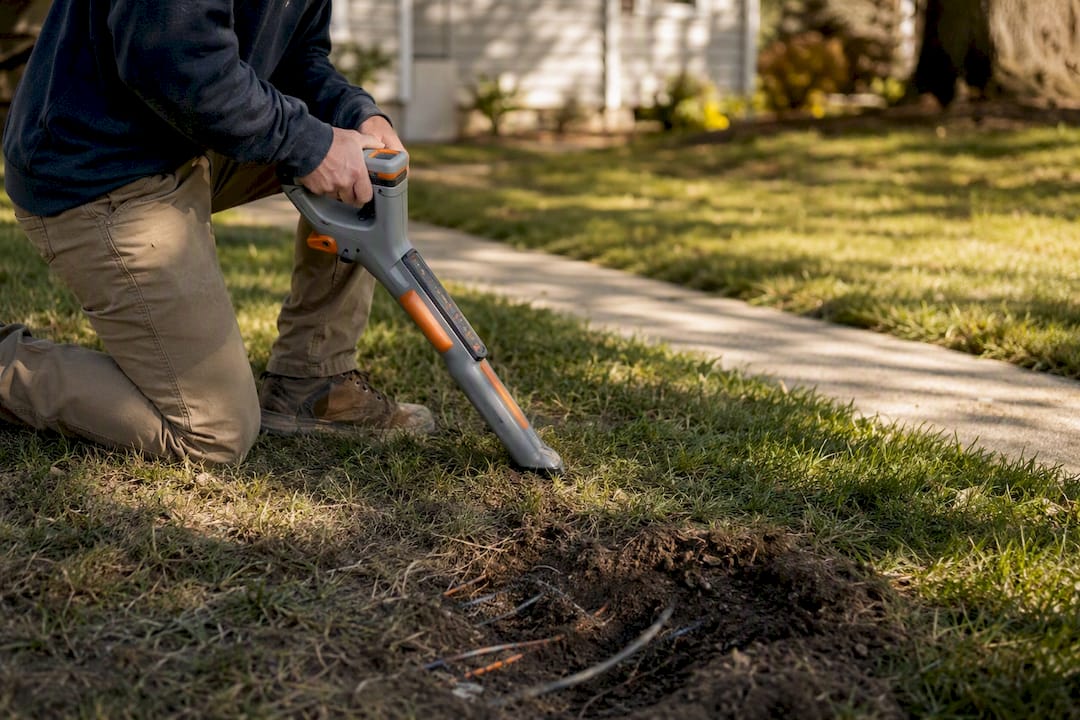

Technician scanning lawn with electronic locator

That is why potholing, exposing a suspected service by hand or with vacuum excavation, remains the accepted verification step across the industry. Vacuum (hydro or air) excavation clears soil without the crushing force of a shovel or auger, which matters when you are working close to a gas main or fiber line. Hand digging works fine for shallow, low-risk spots but takes longer.

Industry safety guidance is direct on the sequencing: mechanical excavation inside a tolerance zone is not permitted until the utility has been visually exposed. Hand digging and vacuum excavation are the only accepted methods inside that zone. Skip that step and you are digging blind with a machine that can shear a pipe in a fraction of a second.

How to Pothole and Confirm Locations Before Digging

Potholing is the physical proof that turns an indicative BYDA plan into something you can trust. State guidance recommends hand digging or hydro/vacuum excavation for this work, never mechanical aids, and specifically warns that plan depths often do not match what is actually in the ground.

Pothole at every point where your excavation crosses a marked service line, at the start and end of any trench run, and at regular intervals along longer runs where the line’s exact path is uncertain.

  • Dig by hand or vacuum excavation only, never with an auger or excavator bucket.
  • Expose the top of the service completely before recording anything.
  • Measure and photograph the depth, alignment, and material of every exposed asset.
  • Share the results with the entire crew before machinery starts moving.
What to Record Why It Matters
Depth from surface Confirms whether marked depth matches reality
Horizontal alignment Shows the service’s actual path versus the plan line
Material and diameter Identifies pipe or cable type for handling precautions
Photo with visible scale Creates an AS5488 Quality A record for the SWMS file

Recording this detail to AS5488 standards also protects whoever works this ground next. A well-documented dig saves a future contractor from repeating your entire verification process from scratch.

What the Law Actually Expects Before You Break Ground

There is no such thing as a guaranteed depth for a buried asset. Soil movement, decades of unrelated works, and undocumented repairs mean a gas line marked at 600mm can turn up at 300mm, or deeper, a few meters along the same trench. Treat every unconfirmed depth as high risk until you have physically checked it.

Asset owners set no-go or exclusion zones around high-risk infrastructure like high-pressure gas mains and high-voltage cable, and those buffers are not negotiable. If a response from BYDA specifies an exclusion zone, mechanical work stays out of it entirely until the owner or their representative clears it.

Anyone with management or control of excavation work must take reasonable steps to obtain current information about underground essential services and build that information into their planning and SWMS. This is not optional paperwork. It is a documented legal duty under WHS regulation, and the Excavation work Code of Practice makes the obligation explicit.

Practical obligations that follow from that duty:

  • Keep a SWMS on site that names the services located, the method used, and who verified them.
  • Have a competent person assess any excavation that could undermine a structure’s footings or stability.
  • Retain your locating records after the job. They protect you if a dispute or a strike investigation comes up later.

Your Checklist Before Any Machine Starts Moving

Run through this before an excavator, trencher, or auger touches the site.

  1. Confirm every BYDA response is logged, dated, and that you have a working contact for each asset owner listed.
  2. Verify potholing is finished at all crossings and along the planned trench route, with services visually exposed and photographed.
  3. Pad or physically protect exposed services so they are not disturbed by foot traffic or material stockpiles.
  4. Check your SWMS reflects the actual findings from potholing, not just the original BYDA plan.
  5. Confirm the machine operator is briefed on exclusion zones and knows exactly where exposed services sit.
  6. Have an emergency response plan ready in case a strike happens anyway.

Skipping any one of these steps is how a routine retaining wall footing turns into a service outage and an incident report.

When to Call In a Certified Locator or an Experienced Contractor

Some sites are straightforward: a suburban backyard, a known service corridor, generous working space. Others are not. Tight side access, a yard with several unmapped private lead-ins, or excavation near a structure’s footings or high-voltage infrastructure all raise the risk enough to justify bringing in specialists.

A DBYD Certified Locator can interpret ambiguous BYDA plans, run electronic detection where it will actually help, and hand you AS5488 Quality A records once potholing is complete. A vacuum excavation contractor brings equipment that clears ground around a suspected line far faster and more safely than a shovel crew, particularly in congested urban yards.

Rokworx works this exact intersection daily, coordinating earthmoving around confirmed service locations for retaining wall footings and rock installations across confined and open sites alike. Our tight-access excavation guide covers the extra planning that cramped side access demands, where a wrong call on locating has nowhere to hide.

Pro Tip: If your BYDA plan shows multiple asset owners overlapping your dig zone, budget for a certified locator upfront rather than after a shovel finds something the hard way.

Why Half-Measures on Locating Cost More Than They Save

The conventional advice stops at “call before you dig” and treats the BYDA response as the finish line. That is where most preventable strikes happen. A plan is a lead, not a location. The gap between what a BYDA enquiry tells you and what is actually sitting in the ground is exactly where potholing earns its keep, and it is the step most homeowners and even some contractors skip because it feels slow.

It is not slower once you count the cost of a severed gas line, a damaged fiber connection, or a week-long project delay while an asset owner repairs what your excavator hit. Potholing a handful of points along a trench run takes a fraction of the time that repair work does, and it produces a record that protects you legally if a dispute follows.

What should change in how you approach this: budget potholing time into your quote from day one, not as an afterthought if the plans look “clear.” Sites that look simple are exactly where private, unmapped lead-ins hide. Prioritize the physical check over the paper trail every time the two conflict.

— MYBMC

Sources

2 Comments

  • 6jiligames

    26 August 2026 - 9:31 pm

    Such a fun way to spend my free time. The games are fair and the rewards keep me coming back for more. Go check out 6jiligames now.

  • wso288login

    31 August 2026 - 8:50 pm

    Quick login and no hassle with the account setup. I appreciate how straightforward everything is here. You guys should try wso288login for a stress free gaming session.

Leave A Comment

x

Get A Quote

    When do you plan on starting this project?
