Retaining Wall With Steps: A Practical DIY Guide

Hands installing concrete block steps on gravel base

For most Australian garden walls under 1 m, the best approach is modular concrete block steps on a 150–300 mm compacted gravel base with a perforated subdrain sloped to an outlet. That combination handles the two things that kill retaining walls: hydrostatic pressure and settlement. If your slope is gentle, the wall stays under 1 m, and there’s no driveway or fence load above it, you can build this yourself over a weekend or two.

Start DIY if: your total rise is under 1 m, the soil is stable, and no structure sits above the wall.

Call Rokworx first if: the wall exceeds 1 m, a driveway or shed sits upslope, the soil is clay-heavy or waterlogged, or you need machinery for excavation or heavy rock placement.

Key Takeaways

A retaining wall with steps built on a compacted gravel base with a properly sloped subdrain will outlast one built without drainage by decades.

Point Details
Drainage comes first Install a 100 mm perforated subdrain sloped to an outlet with 300 mm of clean angular stone backfill before worrying about block choice.
Match riser to block height Plan your riser target around your block dimensions to avoid cuts and keep all risers equal.
Compact every lift Backfill in 150–200 mm lifts and compact each one before setting the next course. Skipping this step causes settlement.
Know your permit trigger In Victoria, most councils require a building permit for walls over 1 m. Get engineering sign-off before you build, not after.
Rokworx for complex jobs When the wall needs rock supply, earthmoving, or engineering coordination in Melbourne, Rokworx handles supply and installation as a single package.

Table of Contents

What types of retaining wall steps work best for your site?

Not every step type suits every yard, and choosing wrong costs you time and money. Here’s how the main options stack up.

Modular block steps are the most popular DIY choice in Australia. You build risers from the same concrete blocks used for the wall itself, then cap them with a matching capstone or paver tread. The big advantage: block heights are standardized, so riser alignment is predictable. Aussiewall and similar systems are widely available through landscape suppliers across Melbourne and Victoria.

Modular concrete block garden steps in backyard

Premade concrete step kits come as single-pour units you drop into an excavated pocket. They’re fast to install and consistent in finish, but they’re heavy (often 80–150 kg per unit), which means you’ll need machinery or a strong crew. The Australian Paving Company (APC) stocks a range of precast step units suited to residential projects.

Capstone-on-block treads use a standard block riser with a wider, thicker capstone as the tread surface. This gives you a clean, finished look and lets you mix textures. The tread overhangs the riser slightly, which softens the visual line and improves foot placement.

Paver or brick treads sit on a compacted sand or mortar bed over the block riser. They offer the widest range of colors and textures, and they’re easy to replace individually if one cracks. The trade-off is that the mortar bed needs to be right, or treads shift over time.

Open-tread gravel options work on gentle slopes where you want a naturalistic look. Timber or steel risers hold gravel in place as the tread surface. They’re low cost and drain freely, but they’re not suitable for steep runs or heavy foot traffic.

Bunnings stocks block kits, capstones, and basic step units that suit straightforward DIY jobs. For larger or more complex projects, landscape suppliers and Rokworx’s rock supply service give you access to heavier materials and better-matched stone.

Pro Tip: Buy blocks and capstones from the same manufacturer range. Matching course heights to your target riser eliminates awkward cuts and keeps the riser-to-tread ratio consistent across the full run. Allan Block’s installation guidance specifically recommends planning stair riser locations to align with standard block dimensions.

What tools and materials do you need before you start?

Getting your procurement sorted before you break ground saves two trips to the hardware store and one very frustrating afternoon. Here’s a compact overview of what you need and where to get it.

Materials: retaining wall blocks (matched to your wall system), capstones or paver treads, clean angular wall rock (free-draining, not crusher dust), 100 mm perforated subdrain pipe, geotextile fabric, landscape adhesive (polyurethane block adhesive), drainage aggregate (20 mm clean crushed rock), and a non-slip tread sealer or abrasive strip for finished surfaces.

Tools: shovel and mattock, tape measure, string line and stakes, 4-ft spirit level, rubber mallet, angle grinder or block splitter for cuts, wheelbarrow, and a plate compactor.

Tool / Material Buy or Hire Typical Australian Source
Retaining wall blocks Buy Bunnings, landscape suppliers, Rokworx supply
Capstones / paver treads Buy APC, Bunnings, stone yards
100 mm perforated drain pipe Buy Plumbing merchants, Bunnings
Geotextile fabric Buy Landscape suppliers, Bunnings
Clean angular wall rock Buy Rokworx supply, quarry depots
Plate compactor Hire Kennards Hire, Coates Hire
Block splitter / angle grinder Buy or Hire Bunnings, tool hire shops
Vibrating rammer (tight access) Hire Kennards Hire

For jobs over about 10 m² of wall face, hiring a plate compactor is worth every dollar. Hand-tamping is slow and rarely achieves the same density, which shows up as settlement within the first wet season.

How do you calculate the number of steps and get the rise and run right?

Target a riser height of around 180–200 mm and a tread depth of 280–300 mm for comfortable garden steps. Those numbers feel natural underfoot and match standard concrete block heights, which makes construction cleaner.

Diagram of calculating retaining wall step dimensions

The formula is straightforward:

Number of risers = Total rise ÷ Riser height
Tread run = Total horizontal distance ÷ Number of risers

Worked example: your slope drops 1.2 m over a 1.8 m horizontal run. Divide 1,200 mm by 200 mm and you get 6 risers. Your available horizontal run is 1,800 mm, so each tread is 300 mm deep (1,800 ÷ 6). That’s a comfortable 200/300 pairing.

If the math gives you a fractional riser count, round up and reduce each riser height slightly rather than leaving one riser taller than the rest. Inconsistent risers are a trip hazard. For public or commercial stairs, Australian building codes cap riser heights and set minimum tread depths, but for private garden steps, the comfort guideline of 180–200 mm riser and 280–300 mm tread is the practical target. The SkyCiv retaining wall design process outlines how preliminary dimensioning and iterative checks apply to the broader wall geometry, which feeds directly into how you size your step run.

How do you prepare the site and excavate a solid base?

A step that settles 20 mm in its first winter looks bad and becomes a trip hazard. The base is everything.

Start by marking the full stair layout with string lines and stakes. Excavate each riser pocket to a depth of at least 150–300 mm below the finished base course level, removing all organic material, topsoil, and loose fill. The base trench should be wider than the block footprint by at least 150 mm on each side to give you working room and allow proper compaction.

Key steps in sequence:

  • Remove organics completely. Roots and topsoil compress unpredictably. Dig until you hit stable subsoil or compactable fill.
  • Lay geotextile on poor soils. If you’re working in clay or silty ground, line the trench with geotextile before placing wall rock. This stops fines migrating up into your drainage layer.
  • Place wall rock in 150–200 mm lifts. Don’t dump the full depth at once. Each lift needs to be compacted before the next goes in.
  • Compact each lift thoroughly. A plate compactor is the right tool for areas wide enough to run it. For tight pockets between risers, use a hand rammer or jumping jack.
  • Check level across the full run before setting the first block. A string line stretched across the base at finished height catches any humps or hollows before you’ve committed to mortar or adhesive.

For Melbourne sites, the Rokworx excavation guide covers local soil conditions and excavation depth considerations that apply specifically to Victorian clay and reactive soils. Embedment for the base course of a small garden wall is typically about one-tenth of the total wall height, so a 600 mm wall needs at least 60 mm of the base course buried below finished grade.

Pro Tip: Hire the plate compactor. The hire cost is trivial compared to re-excavating a settled step two years later.

Why is drainage the most important part of your retaining wall?

Water is the primary cause of retaining wall failure, and it’s the part most DIYers underestimate. A wall with perfect blocks and sloppy drainage will fail. A wall with average blocks and excellent drainage will last decades.

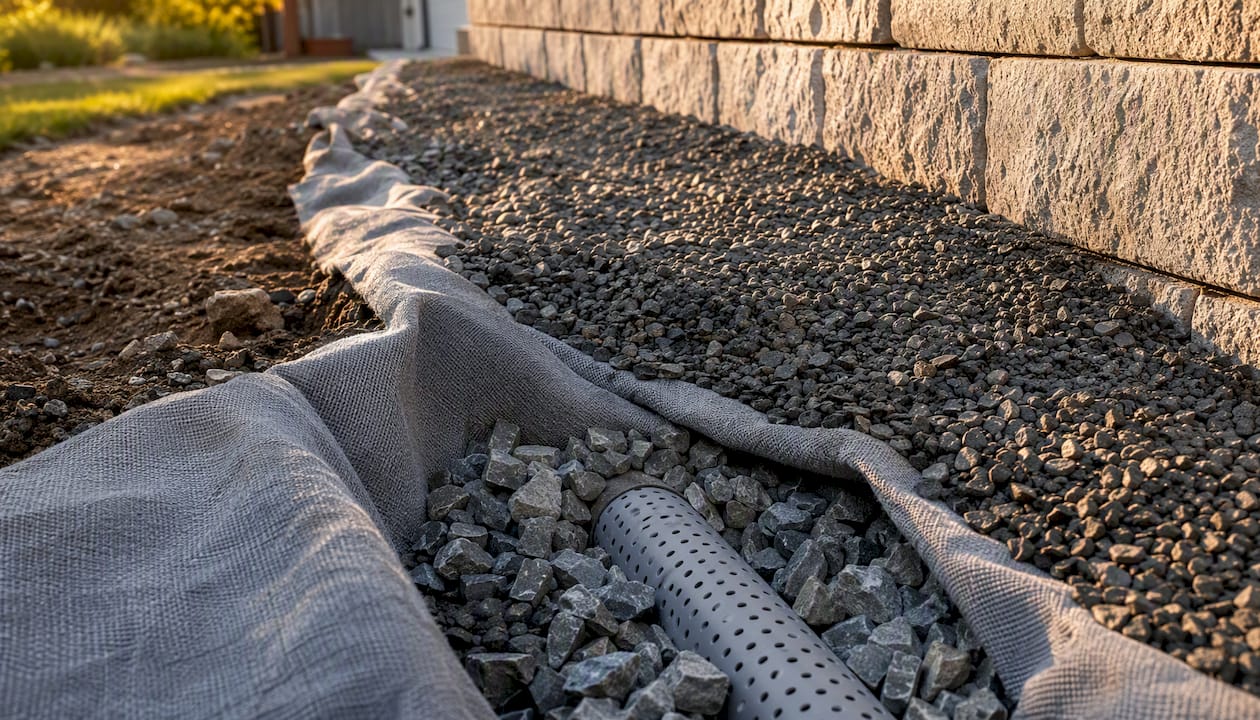

Retaining wall subdrain pipe with drainage rock

Wrap the pipe and surrounding gravel in geotextile to stop fine soil particles from clogging the aggregate over time. Backfill with at least 300 mm of clean angular stone behind the wall stem, compacted in 150 mm lifts.

Installation sequence:

  1. Dig the heel trench at the base of the wall to accommodate the pipe and at least 150 mm of gravel bedding below it.
  2. Lay geotextile in the trench, then place 100 mm of clean gravel.
  3. Set the perforated pipe with perforations facing down, sloped to outlet.
  4. Wrap the pipe and gravel with geotextile and fold over the top.
  5. Backfill with clean angular stone in 150 mm compacted lifts to at least 300 mm behind the wall.
  6. Place weep holes through the wall face at the base course level if the wall design uses solid-face blocks.

Avoid fine soil, crusher dust, or clay backfill behind the drain. These materials hold water and transmit hydrostatic pressure directly to the wall. The Rokworx drainage guide covers local material options and outlet placement for Melbourne conditions.

Pro Tip: Mark your subdrain outlet location on a sketch and photograph it before backfilling. Every year, check that the outlet is clear and flowing freely. A blocked outlet is the single most common cause of wall failure in established gardens, and it’s invisible until the wall starts to lean.

How do you build retaining wall steps from first course to finished tread?

Follow manufacturer instructions for your specific block system on connection details and adhesive. The sequence below applies broadly to block-built and kit-based stairs, but product-specific guidance always takes priority on interlock and bonding. The Spruce’s DIY step guide confirms this same base-first, backfill-as-you-go sequence as standard practice.

Build sequence:

  1. Set the base course. Place the first riser block on the compacted gravel base. Check level front-to-back and side-to-side. Tap into position with a rubber mallet.
  2. Tie into the side walls. Where steps meet the flanking retaining wall, interlock or bond the blocks per the manufacturer’s pattern. This connection carries lateral load, so don’t skip it.
  3. Backfill and compact behind the first riser. Place wall rock in a 150–200 mm lift behind the riser block and compact before setting the next course. This is the step most DIYers rush, and it’s where settlement starts.
  4. Set the second riser course. Place it on the compacted backfill, stepped back by the tread depth. Check level again.
  5. Repeat backfill-compact-set for each riser. Every course gets its own compaction pass before the next riser goes on top.
  6. Fill hollow cores. If your blocks have hollow cores, fill them with concrete or compactable gravel per the manufacturer’s spec. This adds mass and stability.
  7. Install capstones or tread pavers. Apply landscape adhesive to the top of the final riser course, set the capstone or tread, and press firmly. Allow adhesive cure time before foot traffic.
  8. Apply non-slip treatment. Seal or texture the tread surface before the job is complete.

Safety during the build: wear steel-capped boots when handling blocks. Retaining blocks typically weigh 15–35 kg each, and a dropped block on an unprotected foot is a serious injury. Wear eye protection when cutting, and keep the compactor away from freshly set courses until adhesive has cured.

What finish options work best for treads and capstones?

The tread surface is what people touch and walk on every day, so it’s worth spending a few extra minutes on the finish decision.

  • Textured concrete capstones are the most practical choice for most yards. They’re durable, widely available, and their natural texture provides reasonable slip resistance when wet.
  • Natural stone pavers (sandstone, bluestone, granite) look excellent against rock walls and age well in Australian conditions. Bluestone in particular is a popular Melbourne choice for its durability and neutral color.
  • Exposed aggregate concrete gives a non-slip surface without any additional treatment and suits a contemporary or coastal aesthetic.
  • Timber nosing adds warmth but requires regular sealing in Australian UV conditions and is not suitable for high-moisture sites.
  • Gravel infill treads work on low-traffic garden paths but shift underfoot on steeper runs and are not appropriate where elderly or mobility-impaired users will walk.

For non-slip performance, abrasive slip strips bonded to the tread leading edge are the most reliable retrofit option. Surface sealers that include a non-slip additive (aluminum oxide grit) work well on smooth pavers. In Melbourne’s wet winters, any smooth-faced stone or concrete tread benefits from a sealer with grit.

For design inspiration on how treads and capstones integrate with rock walls, the Rokworx project gallery shows finished examples across a range of Melbourne properties. Choosing stone that matches or complements your wall material ties the whole structure together visually.

What mistakes do most DIYers make, and how do you maintain the wall?

Most retaining wall failures trace back to four mistakes, and three of them happen before the first block goes in.

Poor drainage is the most common. Builders skip the subdrain or use crusher dust as backfill, and the wall fails within a few wet seasons. The ISTA Engineers drainage guidance is clear: drainage planning is not optional.

Inadequate compaction is second. Loose backfill settles, which pulls the wall backward and opens gaps between courses. Compact every lift.

Undersized base causes the base course to shift or sink. Minimum 150 mm of compacted wall rock under each riser, full stop.

Mismatched block courses create uneven risers that are both ugly and a trip hazard. Plan your riser height to match block dimensions before you order materials.

Annual maintenance checklist:

  • Clear the subdrain outlet and confirm it’s flowing freely.
  • Remove vegetation growing in block joints or behind the wall face.
  • Check for any leaning, tilting, or bulging in the wall face.
  • Test tread stability by pressing firmly on each step. Any movement means the backfill or adhesive needs attention.
  • Reapply sealer or non-slip treatment if the surface shows wear.

For a detailed maintenance schedule, the Rokworx retaining wall maintenance guide covers Melbourne-specific conditions including reactive clay soils and seasonal water movement.

Red flags that mean stop and call a professional:

  • New cracks appearing in the wall face or footing.
  • Visible leaning or forward movement of any course.
  • Saturated backfill that doesn’t drain after rain.
  • Bulging or bowing in the wall face.

When do you need an engineer and council permits in Australia?

Get an engineer involved before you build, not after something goes wrong. The RISA Blog’s retaining wall design guide outlines the standard professional workflow: site investigation, lateral earth pressure calculation, stability checks, and structural detailing. That process exists because the consequences of getting it wrong are serious.

Triggers for engineering sign-off:

  • Wall height exceeds 1 m (many councils set this as the permit threshold).
  • A driveway, shed, fence, or other structure sits within the surcharge zone upslope.
  • Soil is unstable, waterlogged, or shows signs of movement.
  • The wall retains a slope steeper than 1:1.5.
  • The site is near a boundary, easement, or drainage reserve.

Australian Standard AS 4678 (Earth-Retaining Structures) is the governing document for retaining wall design in Australia. Engineers working on permit-grade walls will reference it for load combinations, material requirements, and stability factors.

The three stability checks engineers run are:

  • Overturning: does the wall resist rotating forward under lateral soil pressure?
  • Sliding: does the wall resist being pushed horizontally along its base?
  • Bearing capacity: can the soil beneath the footing carry the wall’s load without settling?

Per common engineering practice referenced by SkyCiv, target factors of safety are approximately 2.0 for overturning, 1.5 for sliding, and 3.0 for bearing capacity.

What to prepare for a council permit application or engineer’s assessment:

  • Site plan showing wall location, height, and proximity to boundaries.
  • Total rise and horizontal run of the wall and steps.
  • Soil type and any known drainage issues.
  • Surcharge loads (driveway, structures, slopes above the wall).
  • Proposed drainage plan.

Check your local council’s planning portal early. In Victoria, most councils require a building permit for retaining walls over 1 m, and some require one for walls over 800 mm near a boundary.

When should you hire Rokworx instead of going DIY?

DIY works well for straightforward garden walls under 1 m with stable soil and simple drainage. Once the job gets bigger or more complex, the risk-to-reward ratio shifts quickly.

Hire Rokworx when:

  • The wall exceeds 1 m or requires engineering sign-off.
  • The site needs earthmoving or tight-access excavation machinery.
  • You need rock supply for large-format stone or heavy retaining rock.
  • The project involves erosion control, land clearing, or significant cut-and-fill.
  • You want a turnkey supply-and-install outcome with no coordination overhead.

Rokworx’s services cover rock supply, rock retaining wall construction, earthmoving, excavation, and erosion control across Melbourne. For tight-access sites where standard machinery can’t reach, Rokworx has the equipment and experience to work within constrained yards without damaging existing structures.

What to prepare before contacting Rokworx for a quote:

  • Total rise and approximate horizontal run of the wall and steps.
  • Site photos showing the slope, access points, and any structures nearby.
  • Desired finish (rock type, tread style, capstone preference).
  • Known drainage constraints or existing drainage infrastructure.
  • Whether the site requires a permit or engineering assessment.

A site visit is typically arranged after the initial contact to confirm measurements and access. The more detail you provide upfront, the faster the quote process moves.

How much does a retaining wall with steps cost in Australia?

Cost varies significantly by material, wall height, site access, and whether you DIY or hire. These are general ranges based on typical Australian residential projects.

DIY material costs for a basic modular block wall with steps run roughly $150–$350 per square metre of wall face, depending on block type and whether you use capstones or paver treads. A simple 3-step entry on a 600 mm wall might cost $800–$1,500 in materials alone.

Installed costs for professionally built block retaining walls with integrated steps typically range from $350–$800 per square metre of wall face for standard concrete block systems, and higher for natural stone or large-format rock. Steps add cost per unit depending on complexity and tread material.

Factors that push cost up:

  • Poor access requiring machinery or manual handling.
  • Rock or natural stone materials versus standard concrete block.
  • Engineering fees for permit-grade walls (typically $500–$2,000 depending on complexity).
  • Council permit fees (vary by council, typically $200–$800 for residential retaining walls in Victoria).
  • Drainage infrastructure on sites with heavy clay or high water tables.

Getting two or three quotes from local suppliers and installers gives you the clearest picture for your specific site. For rock wall supply and installation in Melbourne, Rokworx can provide a site-specific quote that covers materials, earthmoving, and installation as a single package.

How long does it take to build a retaining wall with steps?

A simple 3–4 step entry on a wall under 600 mm, with stable soil and good access, is a realistic two-day DIY project for a competent homeowner with a helper. Day one covers excavation, base preparation, and drainage installation. Day two covers block laying, backfill, compaction, and tread installation.

Larger or more complex projects scale accordingly:

  • A 1 m wall with 5–6 steps and a full subdrain system: 3–5 days DIY, or 1–2 days for a professional crew with machinery.
  • A wall over 1 m requiring engineering and permits: add 2–6 weeks for the approval process before any physical work starts.
  • Sites with poor access, heavy clay, or significant earthmoving: add 1–3 days for excavation and material handling.

Adhesive cure time is a practical constraint. Most landscape block adhesives need 24 hours before foot traffic, so plan the tread installation as the last step before you walk away for the day. In cold Melbourne winters, cure times can extend, so check the product data sheet.

The permit process is often the longest variable. If your wall needs council approval, lodge the application before ordering materials. Waiting on a permit with a pallet of blocks sitting in your driveway is a frustrating way to spend a fortnight.

What installers check first on every step job

Every experienced installer starts at the same place: the outlet. Before a single block goes in, the drainage outlet location determines everything else about how the subdrain runs, where the pipe exits, and whether the whole system will actually work. Get the outlet wrong and the rest of the drainage design is academic.

The second thing that separates a good installation from a mediocre one is compaction sequencing. On tight-access Melbourne sites, Rokworx sequences rock placement and compaction so that each lift is fully compacted before the next course of blocks goes in, even when working in confined yards where a full-size plate compactor won’t fit. A jumping jack rammer in a narrow access lane achieves the same density as a plate compactor on an open site, but only if you give it enough passes.

Rokworx can handle the supply, earthmoving, and installation

When the project goes beyond a weekend DIY job, Rokworx covers the full scope: rock supply, retaining wall construction, earthmoving, and tight-access excavation across Melbourne. You get one point of contact for materials and installation, which cuts the coordination time that typically blows out project timelines.

Rokworx

For a quote, have these ready: site photos, total rise and run measurements, desired finish and rock type, access notes, and any known drainage constraints. Rokworx will arrange a site visit to confirm the scope and provide a fixed quote covering supply and installation.

Browse rock wall ideas and completed projects to get a clear picture of finishes and step styles before your site visit. For Melbourne homeowners ready to move forward, visit the retaining walls Melbourne service page or contact Rokworx directly to book an assessment.

Sources

3 Comments

  • 49betlogin

    25 August 2026 - 6:55 am

    I’ve tried many sites but the user interface here is by far the most intuitive. Easy to navigate and easy to win. Visit 49betlogin for the best action.

  • asianslot88

    31 August 2026 - 9:41 am

    [4942]asianslot88 | Login Resmi & Situs Slot Gacor Hari Ini Terpercaya,asianslot88 menyediakan akses login resmi dengan kemudahan download apk serta panduan deposit dana casino yang praktis. Cek pola slot pragmatic terbaru di sini. visit: asianslot88

  • bdtask71

    8 September 2026 - 9:07 am

    The efficiency of this site is impressive. No lags and the registration process was a breeze. Very happy with bdtask71

Leave A Comment

x

Get A Quote

    When do you plan on starting this project?
